Project Ketchum

Project Ketchum

City of Ketchum

  • Home
  • City of Ketchum
  • Stay in the Loop

Project Main Street

Rebuilding the roadway and improving pedestrian amenities from River to 6th Street, in partnership with Ketchum Urban Renewal Agency and Idaho Transportation Department

Main Street construction update (4th through 6th Street)

Construction on Main Street between 4th and 6th Street, which began on Monday, April 7, is progressing well, and electrical work and curb and sidewalk demolition are underway. The existing roadway has been removed, and unlike last year, the foundation will not require replacement. The sidewalk work on 2nd Street (south of the Culinary Institute) will be completed by the end of the week. Completion dates are still on schedule:

  • Full street closure: April 7 to July 3
  • Rolling sidewalk closures: April 7 to late July

We appreciate your continued patience as we work towards revitalizing the last section of Main Street.

(Updated 5-1-25)

Receive Main Street updates by email and/or text

* indicates required
    Up next

    (Updated 5-1-2025)

    Elkhorn to River Street Project underway: The Idaho Transportation Department kicked off their Elkhorn to River Street Project on April 29. Stay in the loop on their progress at itdprojects.idaho.gov/pages/idaho75.

    ITD-South-of-Town-PlansDownload
    Click here to receive ITD’s project updates

    Sidewalk project on 5th Street between Main Street and Leadville Avenue: A sidewalk and retaining wall are being added to the south side of this street section for improved pedestrian and business access. Work is underway and is scheduled for completion by Memorial Day.

    Access

    (Updated 5-1-2025)

    Access to businesses will be open throughout construction. Through traffic should use the detour route: Serenade Lane to 2nd Avenue, 8th Street to Warm Springs Road, then 10th Street to Highway 75.

    Please note that the bus will be operating on the detour route with the temporary bus stops along the route.

    Main-Street-DetourDownload
    Timeline

    The phases outlined below are intended to give a general idea of construction plans. Slight shifts to these plans may occur throughout construction.


    Phase 1 (complete)

    April 1 to early May 2024 (complete)

    2nd Street-4th Street

    • April 3-30: Roadway closures for utility and infrastructure work
    • April 19-May 2: Intermittent sidewalk closures (2nd to Sun Valley Road only) for demolition and infrastructure

    Phase 2 (complete)

    May 1 to early August 2024 (updated July 25, 2024)

    2nd Street-4th Street

    • May 1-late July: Roadway closures for demolition, foundation, and paving
    • May 3-early August: Intermittent sidewalk closures for demolition, infrastructure, and paver installation

    Note: Idaho Power will install a redundant power line during Phase 2 of Main Street construction that requires the following closures.

    • April 29-May 24: Main Street between River and 2nd Street and 2nd Street from Main Street to Leadville
    • May 25-June 9: 2nd Street from Leadville to East Avenue
    • June 10-14: 2nd Street from East Avenue to Alpine Lane
    • June 15-21: 2nd Street from East to Walnut Avenue
    • June 24-July 3: 2nd Street from Walnut to Spruce Avenue
    • July 8-26: 2nd Street from Walnut to Spruce Avenue and Spruce Avenue from 2nd to Sun Valley Road

    Phase 3 (complete)

    Late July to early October 2024 (updated July 25, 2024)

    River Street-2nd Street

    • Late July-mid September: Roadway closures for demolition, foundation, and paving
    • Early August-early October: Intermittent sidewalk closures for demolition and paver installation

    Phase 4

    April to July 2025 (updated October 24, 2024)

    4th Street-6th Street

    • Roadway closures for demolition, foundation, and paving
    • Intermittent sidewalk closures for demolition, infrastructure, and paver installation
    Support businesses

    All businesses are open and accessible during construction, and directional signage is located around construction areas.

    Support local and score $15! Select Main Street restaurants and retailers adjacent to construction are once again teaming up with the city and offering free $15 vouchers to spend at their respective businesses from April 16 through July 14. Pick up your free voucher at the Ketchum Visitor Center (491 Sun Valley Rd.) during operating hours. Limit one voucher per person.

    Participating businesses

    Backwoods Mountain Sports
    Black Tie Ski & Bike Rentals
    The Burger Grill
    Business as Usual
    Fherty
    Johnny Was
    Lost River Outfitters
    Sawtooth Brewery
    Silver Creek Outfitters
    Veltex
    Worth Repeating Consignment
    Background

    Ketchum will be rebuilding the roadway and improving pedestrian amenities from River through 6th Street, in partnership with Ketchum Urban Renewal Agency and Idaho Transportation Department.

    Project goals

    • Rebuild the roadway
    • Improve travel efficiency during peak travel times

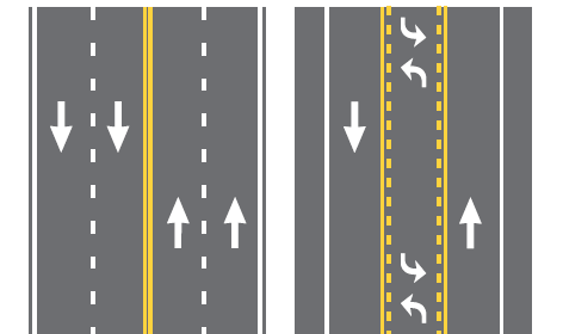

      • Reconfigure Sun Valley Road intersection by adding designated left turn lanes on Main Street
      • Upgrade traffic signals to decrease unused “green” time
      • Synchronize traffic lights for better traffic flow
    • Improve ADA/pedestrian realm and safety at crosswalks
      • Install bulbouts to decrease pedestrian crossing distance at corners
      • Install raised intersection at Sun Valley Road for ADA accessibility and better view of pedestrians
    • Address the issue of “no left turns” in Ketchum
    FAQs

    Frequently Asked Questions:

    Why did Phase 3 change from 4th through 6th Street to River through 2nd Street?
    • Phase 2 delays caused by the unavailability of contractors and materials and the unexpected need to replace Main Street’s foundation pushed back the start date of Phase 3. Since ITD only allows roadway paving to take place before October 15, it also meant 2 blocks of the project would have to be done in 2025. It was decided to complete River through 2nd Street first and do 4th through 6th Street in 2025 because it would conflict less with Labor Day events in 2024 and ITD’s work south of River Street beginning in early spring 2025 and taking place through 2026.
    Why are full road closures required?
    • Main Street’s foundation was in much worse condition than ITD originally anticipated, and it needs to be replaced. The roadway must be fully closed to do this.  Also, underground improvements (power, irrigation, and storm drainage) can be done faster if with full road closures, and the public overwhelmingly favored completing the project as quickly as possible.
    Did you consider closing just one block at a time?
    • Yes. However, it would take more time to complete the project and cost more—downsides not favored by the majority of public input received.
    What has caused construction delays during Phase 2?
    • You are likely aware that the City’s original request for bids on the project resulted in no interested contractors. This immediately delayed the project until an interested contractor could be secured. Phase 2 began with hopes the roadway between 2nd and Sun Valley Road could reopen by early July while the sidewalks in the area would be completed later in the month. The contractor then had trouble securing subcontractors and equipment for electrical and curb work. Shortages of materials such as signal mast arms and controller boxes further affected delays.

      In mid-July of 2024, it was determined that ITD’s original geotechnical survey of Main Street’s subsurface was not correct, and the foundation would need to be replaced before paving could proceed. This pushed completion back even more, resulting in an end of July 2024 completion for the roadway and early August completion for the sidewalk between 2nd and 4th Street.

      Despite these unfortunate circumstances, the city and project partners — contractors, subcontractors, ITD and engineers — have been flexible to find solutions to complete the work as quickly as possible, while ensuring the budget and work quality is not compromised.
    When will the project be completed?
    • The entire project scope includes roadway and sidewalk improvements on Main Street from River through 6th Street. Work from River to 4th Street was completed in October of 2024. Work from 4th to 6th Street will be completed by the summer of 2025.
    Why was construction from 4th to 6th Street not included as part of the work in 2024?
    • The reasons: cost and time. Contractor estimates for work from River to 6th Street exceeded the combined ITD, City of Ketchum, and KURA contributions. And limited contractor availability pushed the work north of 4th Street to 2025. The city worked with ITD to receive more funding and work is now scheduled to complete 4th through 6th Street in 2025.
    Is the project on budget?
    • Yes, the project from River to 6th Street remains on budget.
    Plans

    Images of construction plans coming soon…

    Resources
    View the 90% Design Drawings Presentation
    Nov 9 | Public Meeting Recording
    Nov 13 | Joint Meeting Recording
    Jan 11 | Public Meeting Recording
    Feb 16 | Public Meeting Recording

    Community Conversations

    Main Street Presentation | Streetscape Design | Survey Results
    Main Street Presentation | Streetscape Design | 1.11.24
    Main Street Presentation | 30% Design Drawings | Survey Results
    Main Street Presentation | 30% Design Drawings | 11.13.23
    Main Street Presentation | 30% Design Drawings | 11.8.23 & 11.9.23
    Main Street Rehabilitation discussion | 6.14 & 6.15.23 | deck
    Main Street Rehabilitation discussion | 6.14.23 | video
    (Draft) Main Street Alternatives Analysis Report | 11.21.22
    Survey results | 10.18.22

    Related Resources

    Elkhorn to River Street – ITD’s 2025/2026 project
    ITD’s Geotechnical Report of Main Street
